Balephi Khola · Sindhupalchok, Nepal

Balephi-A Hydropower Project

22.14 MW run-of-river plant, over 90% built

Power sold to NEA under a 30-year agreement

IPO underway: issue manager and underwriter appointed

Balephi-A Hydropower Project powerhouse
Installed Capacity
22.14MW
Annual Energy Output
125.3GWh
Gross Head
86m
Overall Physical Progress
90.58%
IPO update

SEBON review and approval of the issue In progress

Investor Relations

Who We Are

Over 90% built on the Balephi Khola.

More About Us

Moonlight Hydropower Company Limited was set up in 2006 to build the Balephi-A Hydropower Project in Sindhupalchok District. The plant takes water from the Balephi Khola at a 33 m diversion weir, clears the sediment in a settling basin and carries the flow through a 948 m canal and a 2.3 km steel pipe, 3.8 m across. From there the water drops 86 m to a powerhouse with three Francis turbines. At 22.14 MW, the plant is expected to produce about 125 GWh a year, all of it sold to the Nepal Electricity Authority.

  • PPA with NEA for the full 22.14 MW
  • 90.58% physically complete (August 2026)
  • Roads, irrigation and temple protection for local communities
Kalyan Bikram NeopaneChairman, Moonlight Hydropower

Board of Directors

The People Steering Moonlight

Three directors oversee the company and the construction of Balephi-A.

Meet the Full Team
  • Mr. Kalyan Bikram Neopane

    Mr. Kalyan Bikram Neopane

    Chairman

    More than 12 years in civil construction and hydropower
  • Mr. Sudhir Lamichhane

    Mr. Sudhir Lamichhane

    Director

    More than 20 years in corporate management
  • Mr. Bed Prakash Bista

    Mr. Bed Prakash Bista

    Director

    More than 15 years in corporate management

Why Balephi-A

A Plant Built to Run for Decades

A run-of-river plant has no fuel bill. Balephi-A’s income is fixed by a long-term tariff agreement with Nepal’s national utility, and its output adds to the dry-season power Nepal needs most.

  1. Over 90% Built

    The headworks, settling basin, forebay and surge tank are finished. Remaining work is mainly on the penstock, the turbines and generators, and the 33 kV line.

  2. A Contracted Buyer

    The Nepal Electricity Authority buys the plant’s output under a power purchase agreement that runs for 30 years from commercial operation.

  3. Dry-Season Tariff

    Rs 8.40 a unit from December to May and Rs 4.80 in the wet months, with 3% yearly escalation on the base rate in the early years.

  4. Local Benefits

    About 9 km of village roads, an irrigation canal, and protection works for the Mahadev Mandir and a local school.

542.65km²
Catchment Area
32.4m³/s
Design Discharge
124.56GWh
Contracted Energy a Year
30yrs
Power Purchase Agreement

Construction

Where the Work Stands

90.58%

Overall Physical ProgressAs of August 2026

  • Access Road90%
  • Land Acquisition & Compensation95%
  • Hydromechanical Works70%
  • Electromechanical Works70%
  • Transmission Line67%

Site Updates

Structure by Structure

  • 01100% complete

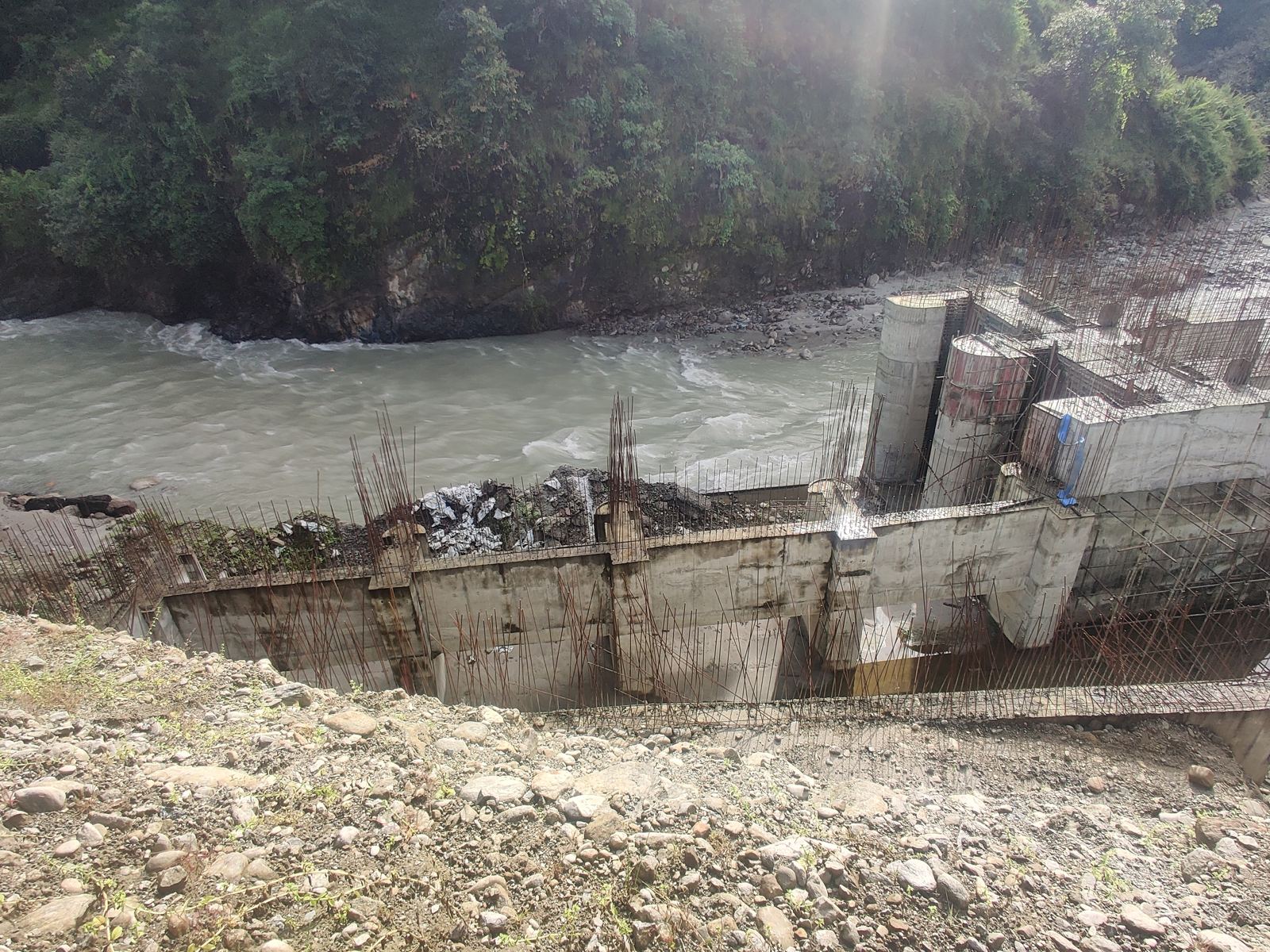

    Headworks

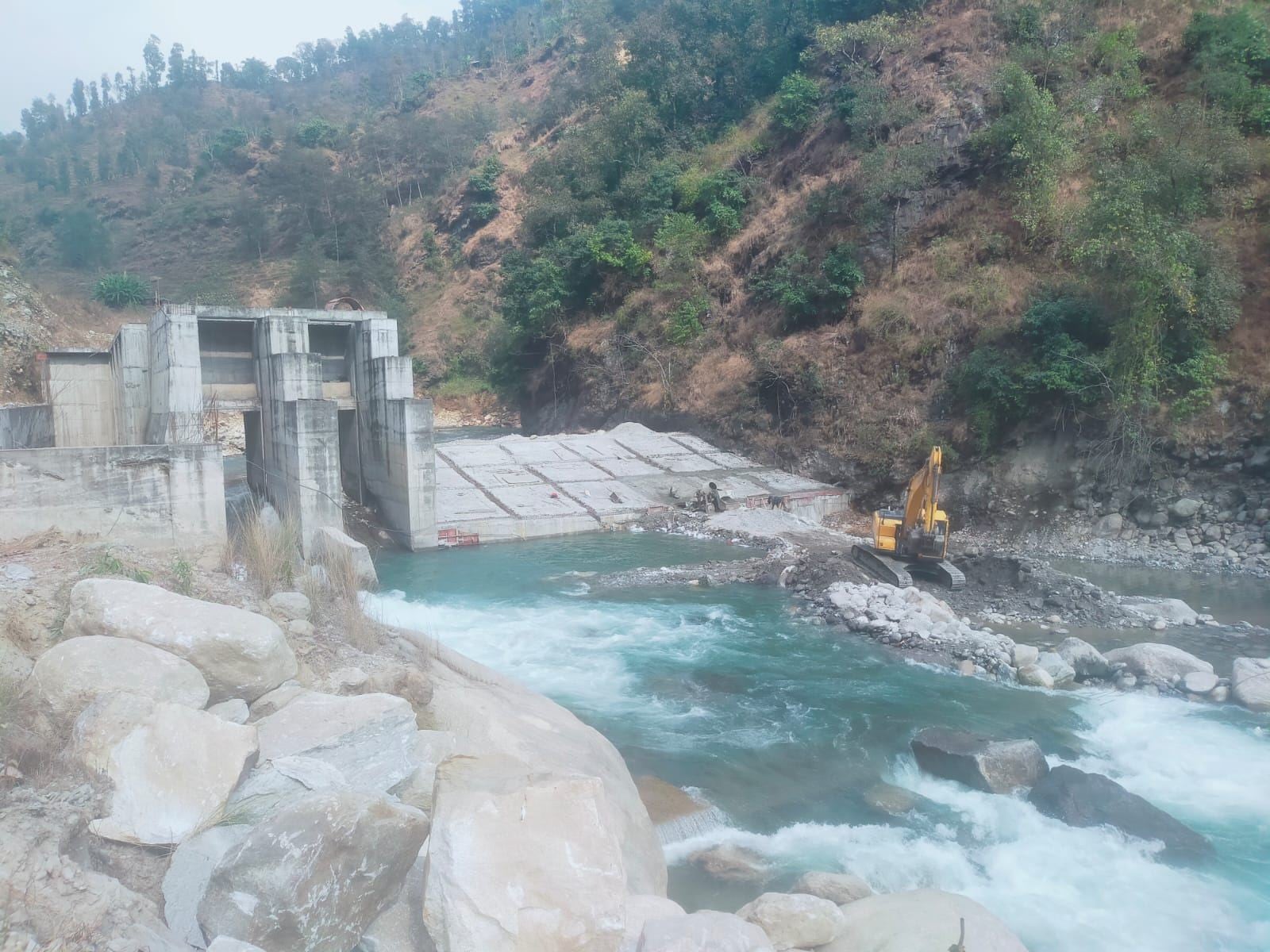

    The weir, intake, under-sluice, spillway and gravel trap are fully constructed at the headworks site.

    Read update
  • 02100% complete

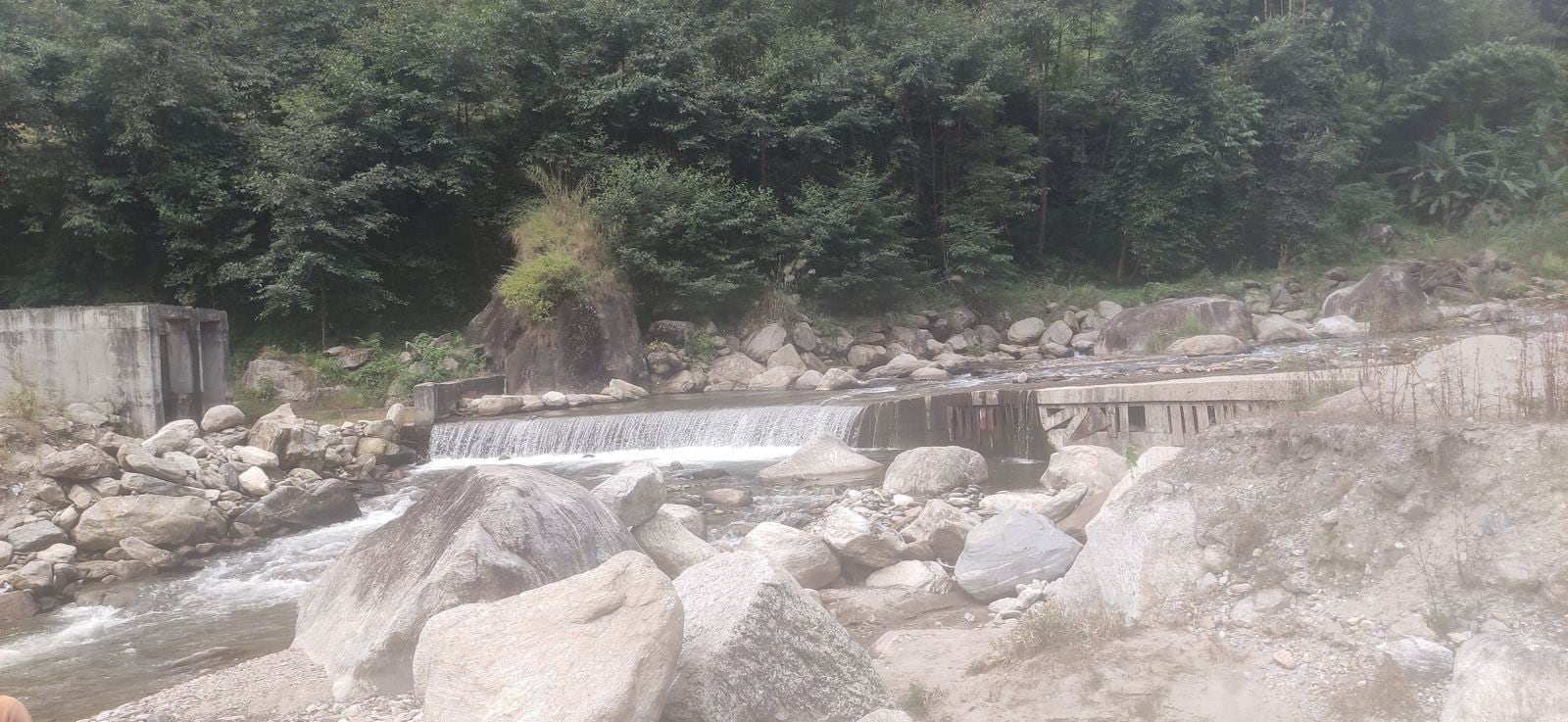

    Approach Canal

    The 82 m approach canal connecting the gravel trap and the settling basin is fully complete.

    Read update
  • 03100% complete

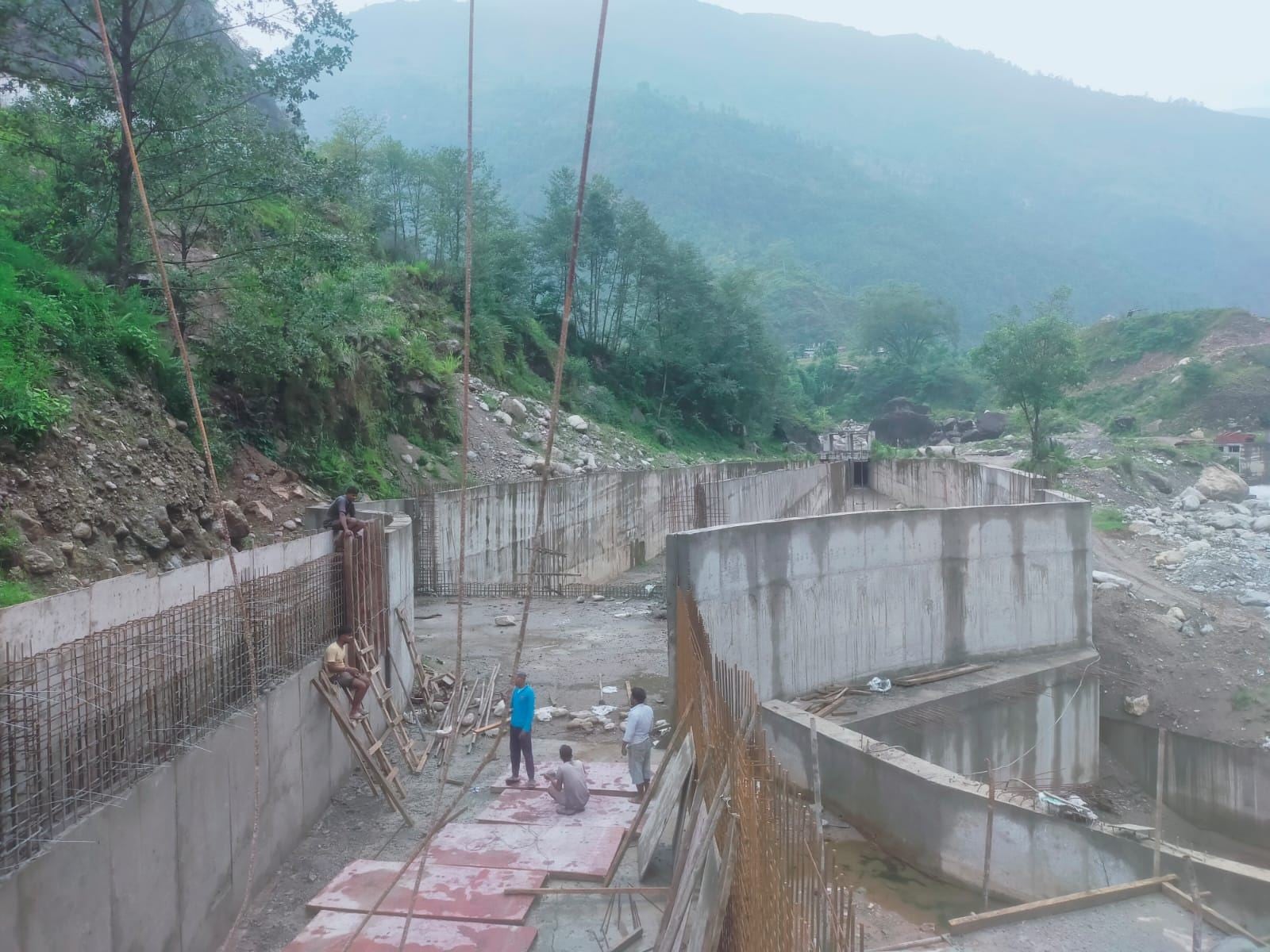

    Settling Basin

    Excavation, the main body, the pond and the hopper wall of the settling basin are complete.

    Read update
  • 0495% complete

    Headrace Canal

    910 m of the 948 m headrace canal linking the settling basin to the forebay is complete.

    Read update
  • 05100% complete

    Forebay

    Site clearance, the bottom slab, side walls and bellmouth installation are fully complete.

    Read update
  • 0670% complete

    Hydromechanical Works

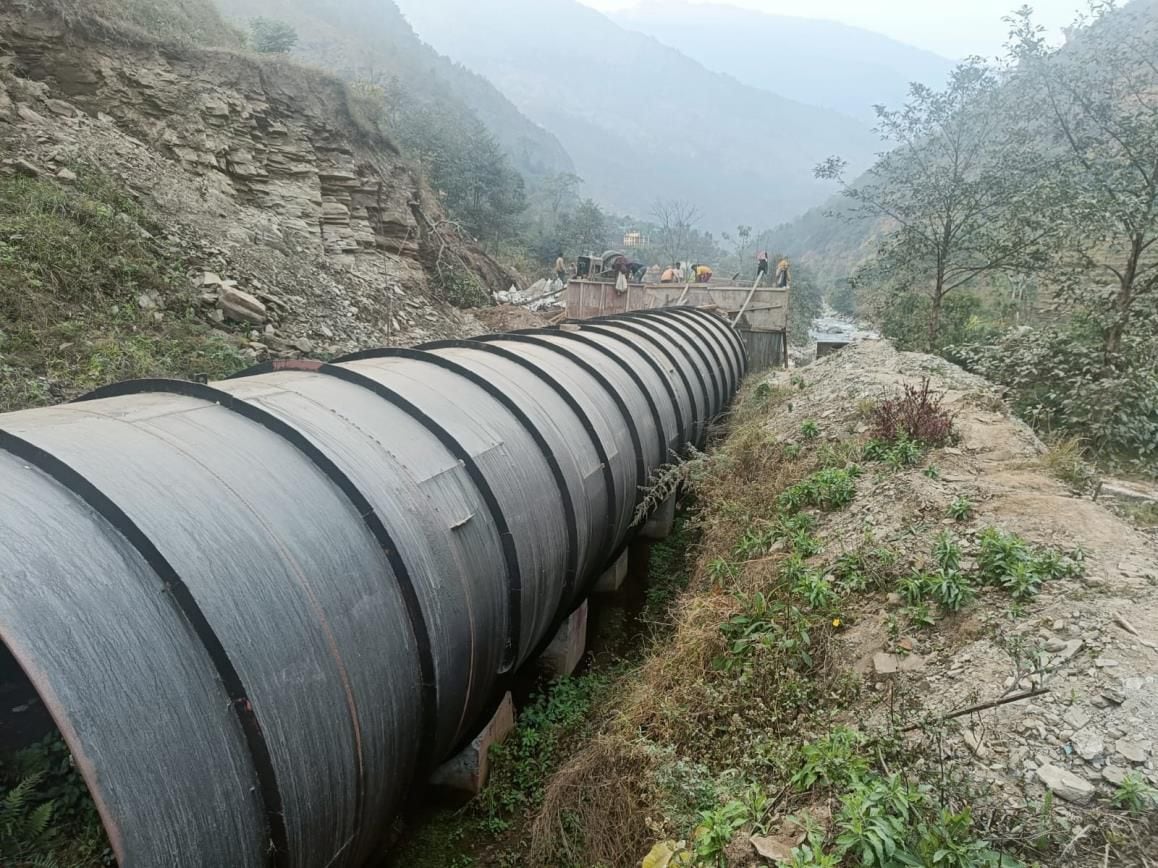

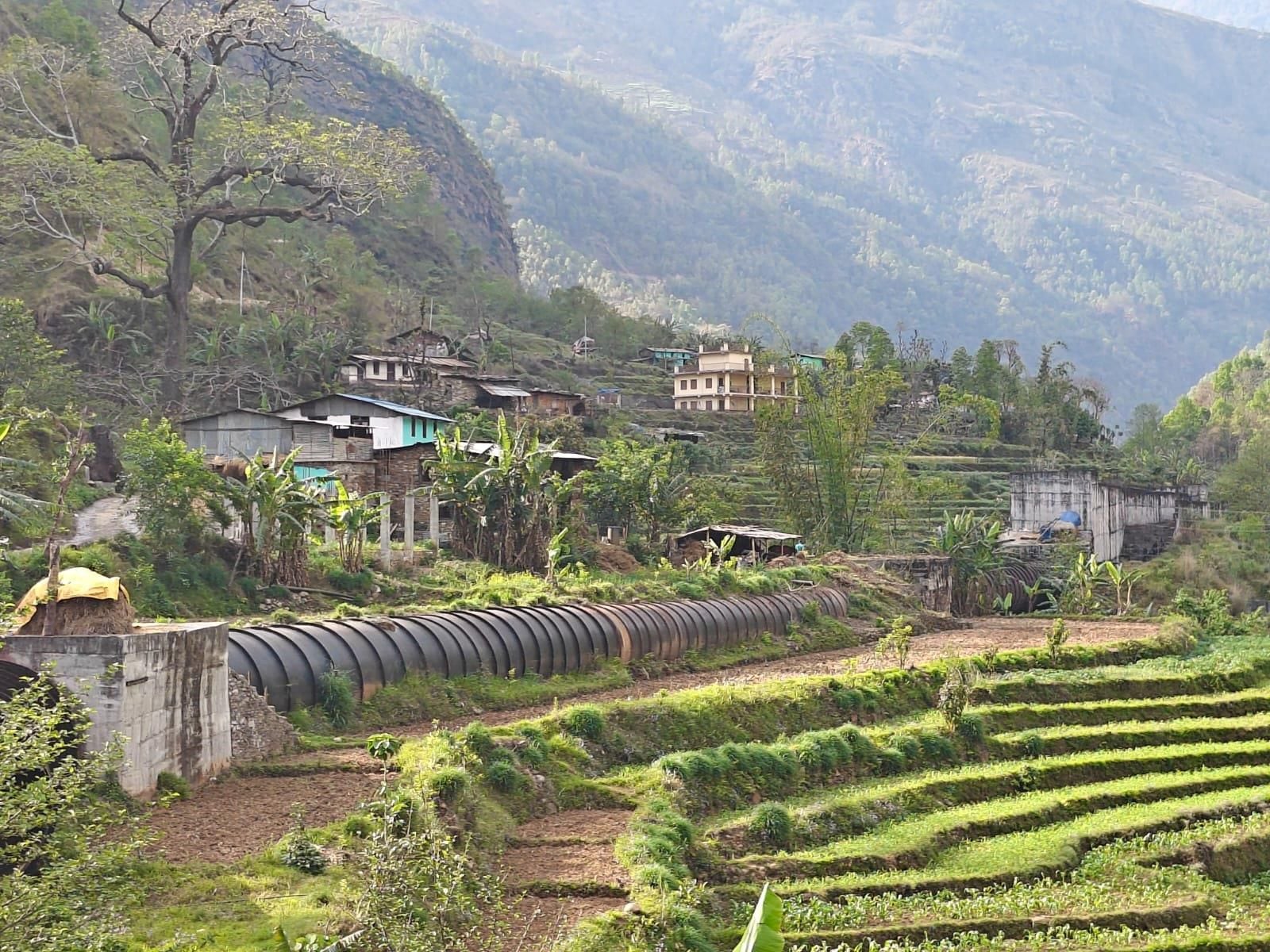

    Of the 2,945 m of combined headrace and penstock pipe, about 2,061 m has been rolled and erected.

    Read update
  • 07100% complete

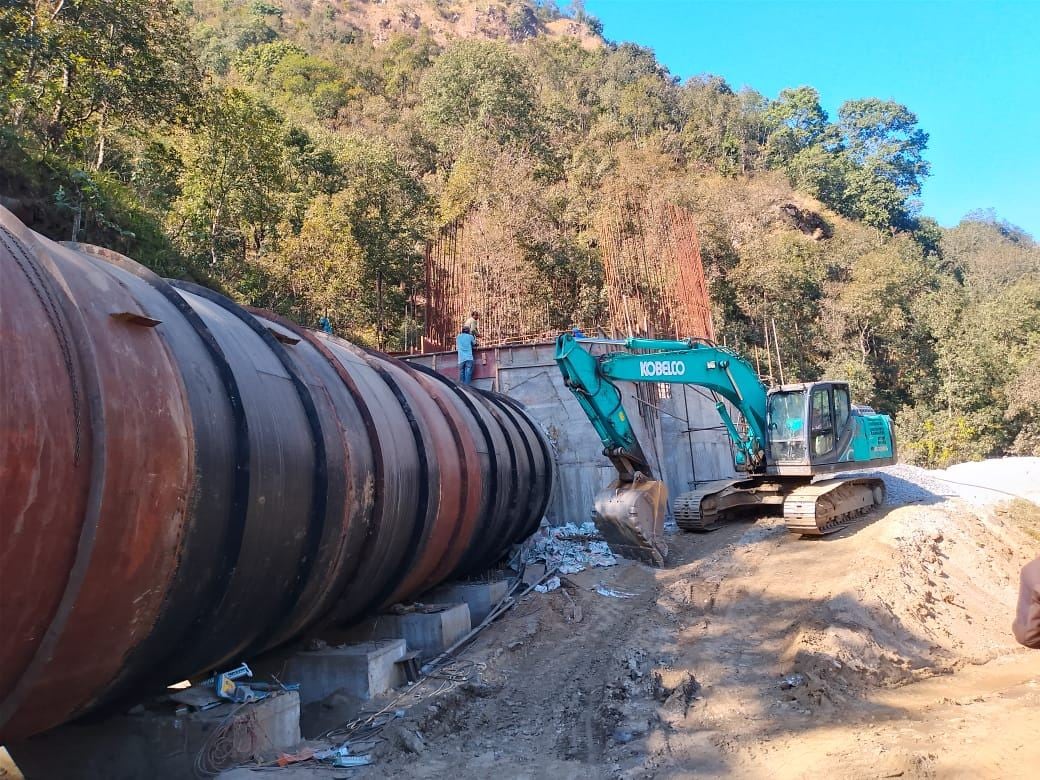

    Surge Tank

    The surge tank has been fully excavated and constructed.

    Read update
  • 0860% complete

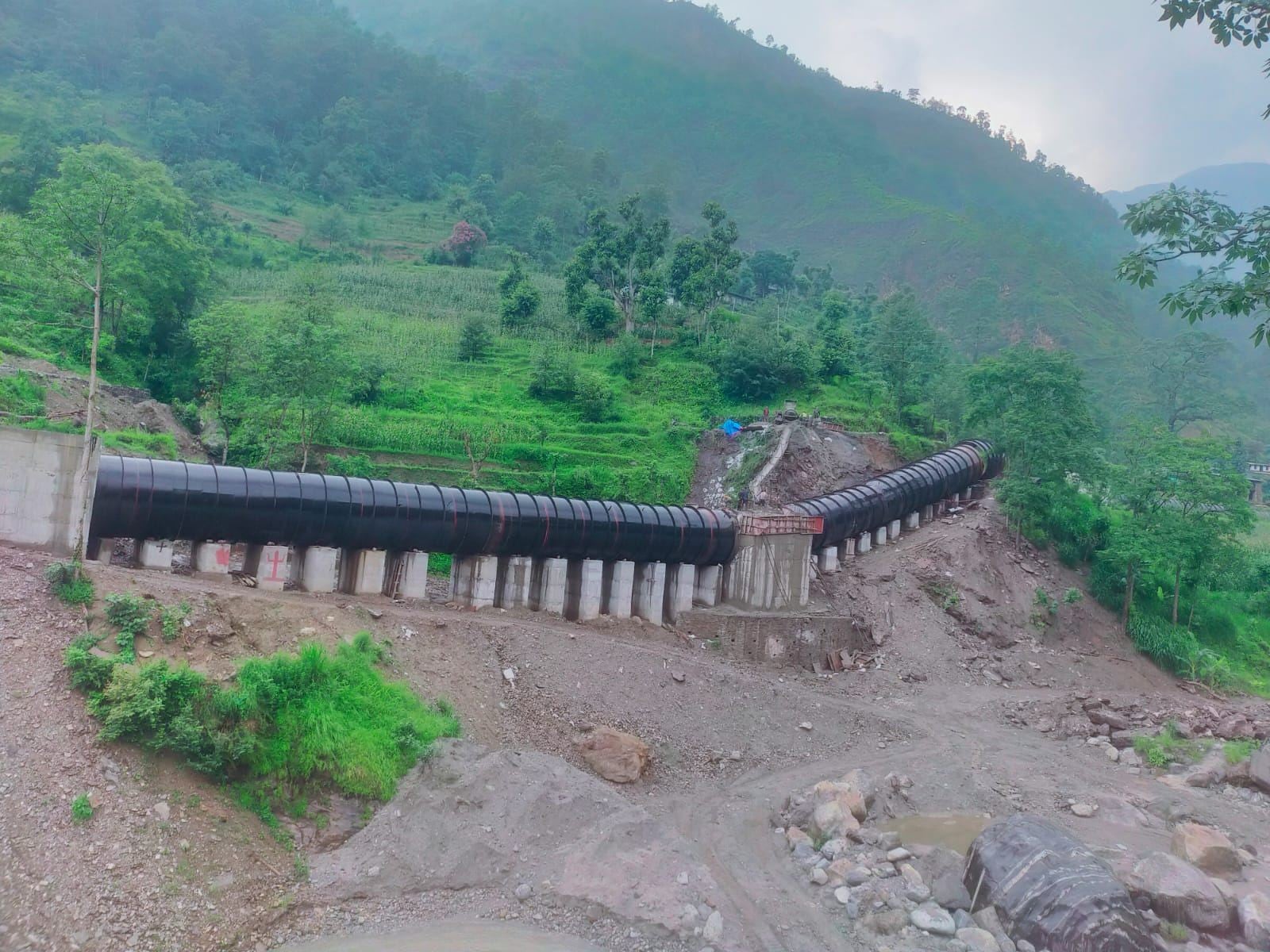

    Penstock

    Site clearance, excavation and construction of saddle supports and anchor blocks are underway along the penstock alignment.

    Read update
  • 0995% complete

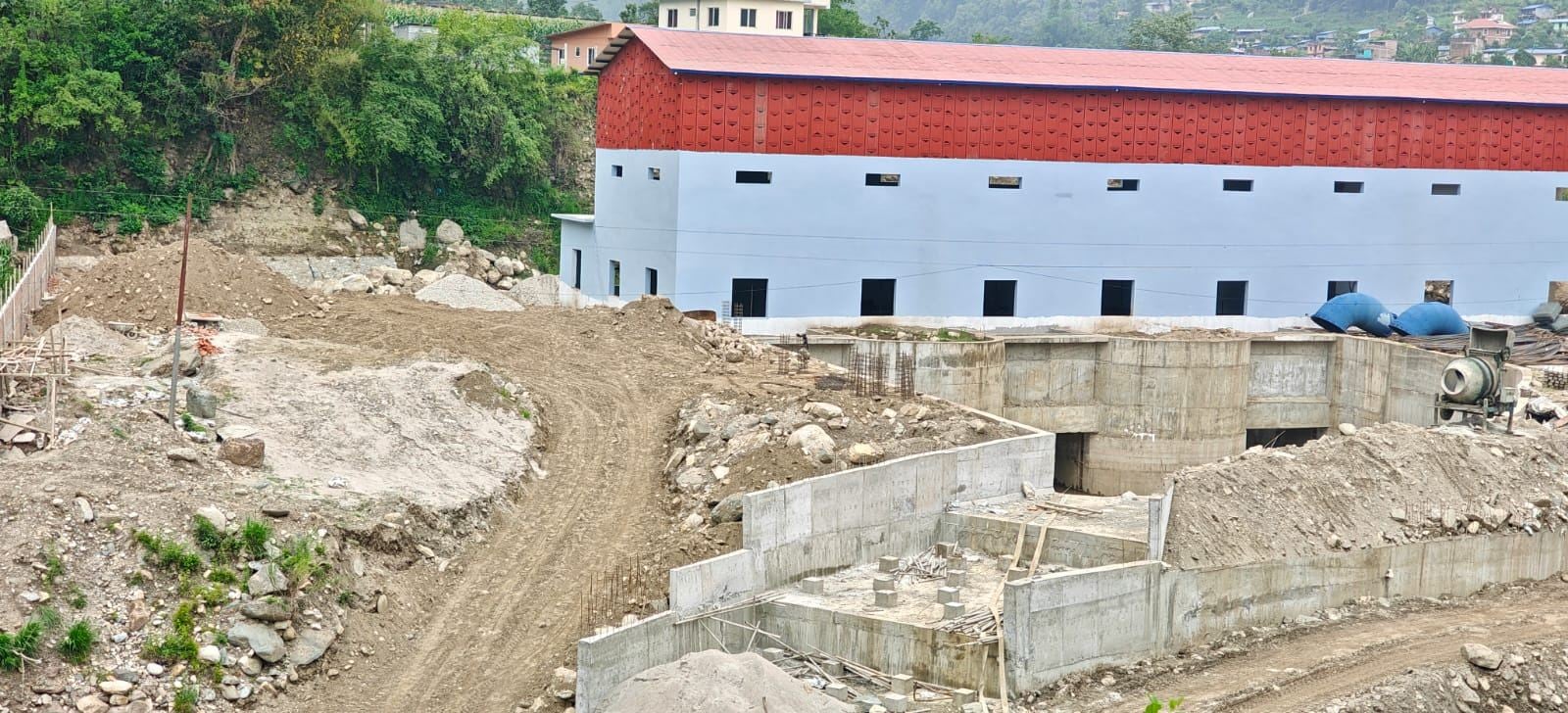

    Powerhouse

    The foundation, earth mat, PCC works and superstructure are complete, and finishing works continue. Turbine and generator components, including the draft tube and main inlet valve, are being delivered and installed.

    Read update
  • 1070% complete

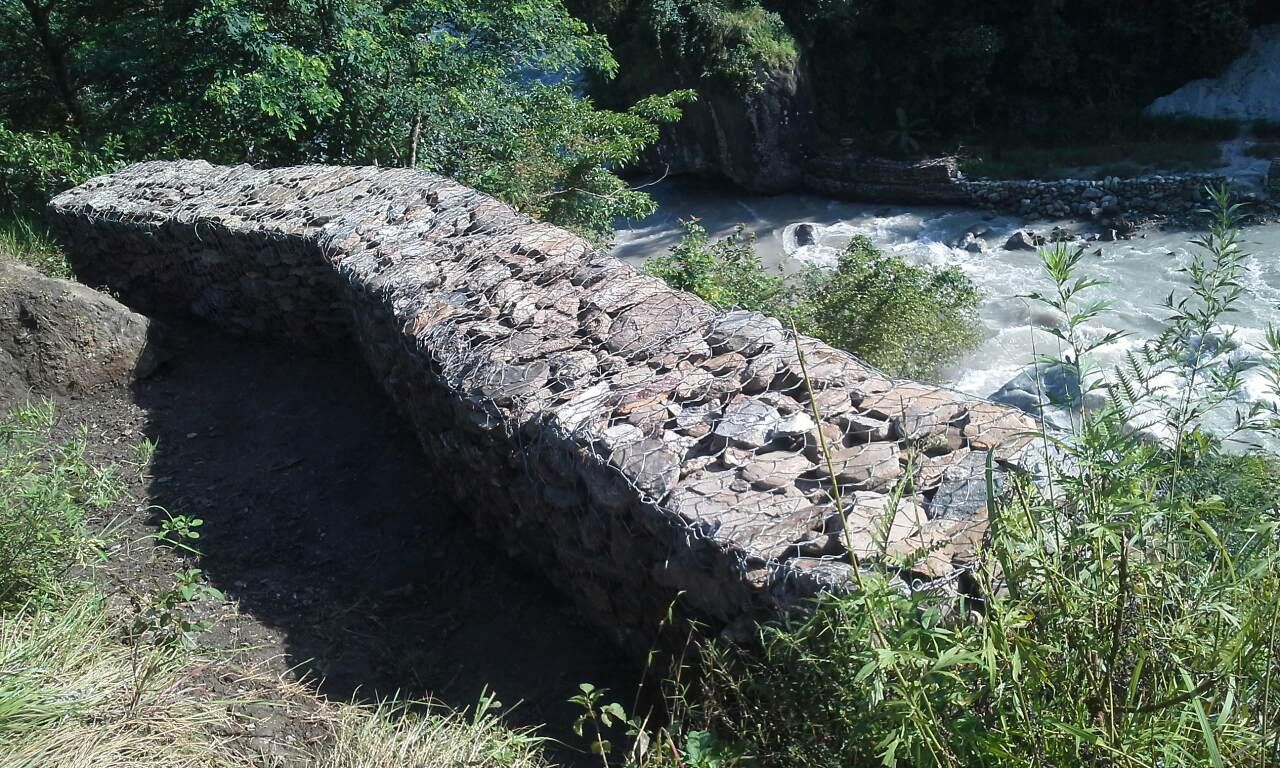

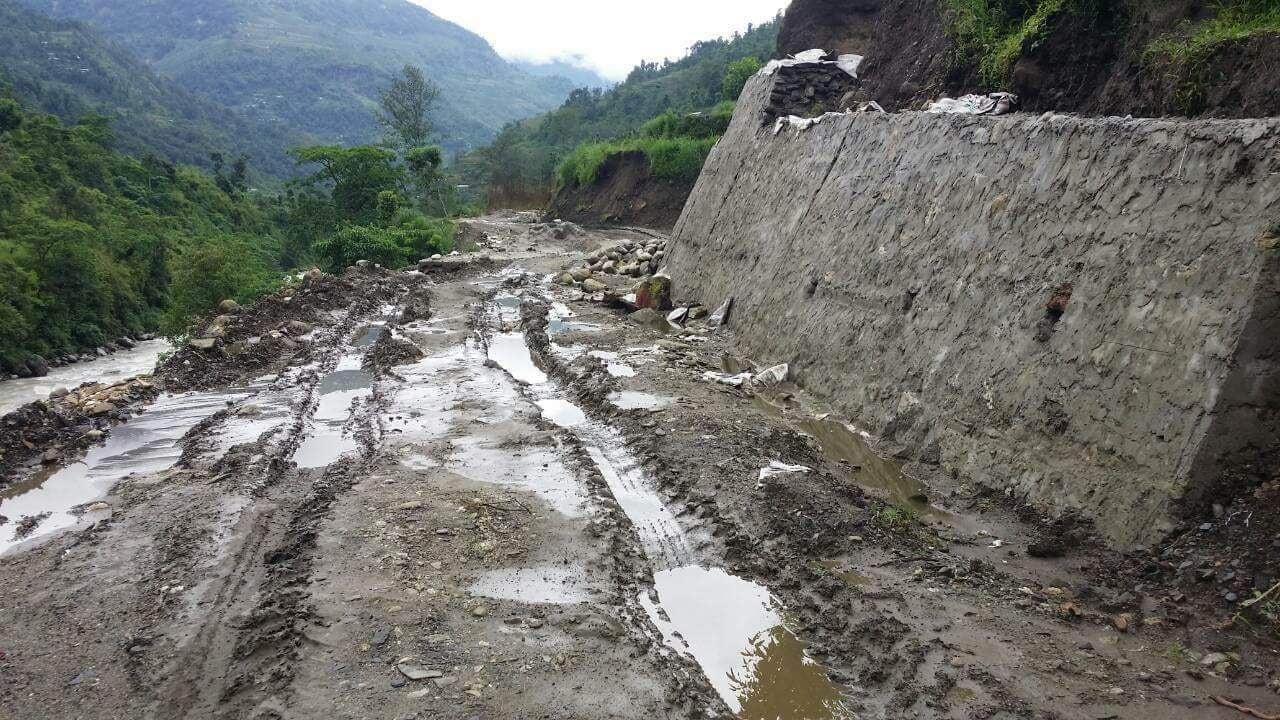

    Protection Works

    Stone masonry retaining structures are under construction to protect key project areas.

    Read update
  • 11100% complete

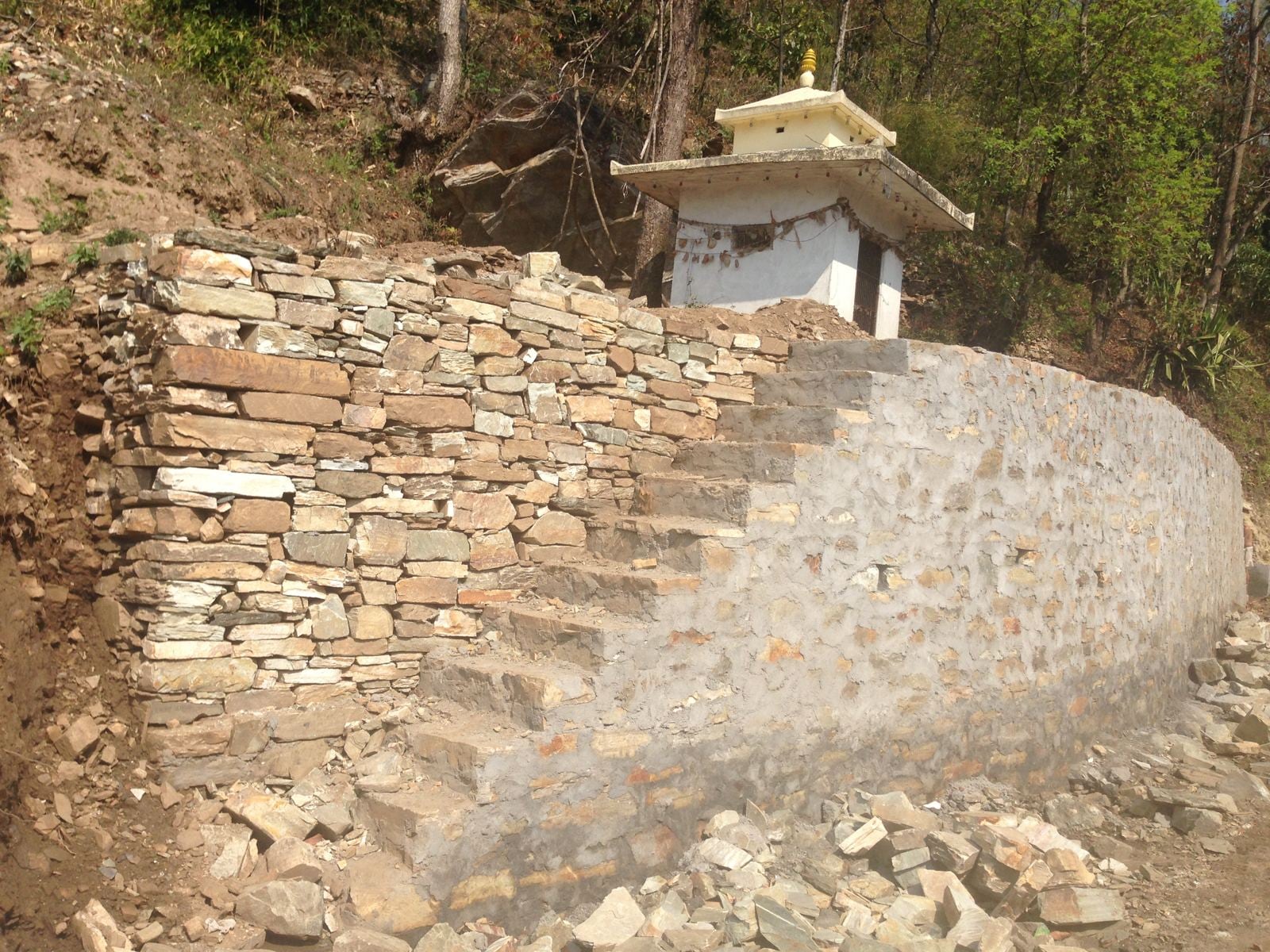

    Social Mitigation

    About 9 km of local roads, an irrigation canal, and protection works for the Mahadev Mandir and a local school are complete.

    Read update
  • 1280% complete

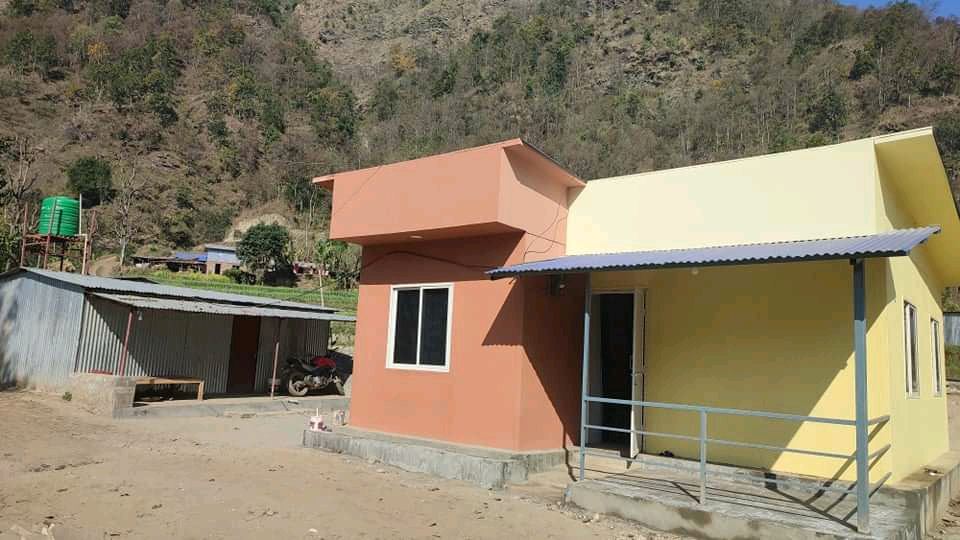

    Infrastructure & Site Camp

    Site camps, stores, stockyards and fabrication workshops are in place near the headworks and powerhouse.

    Read update
  • 1390% complete

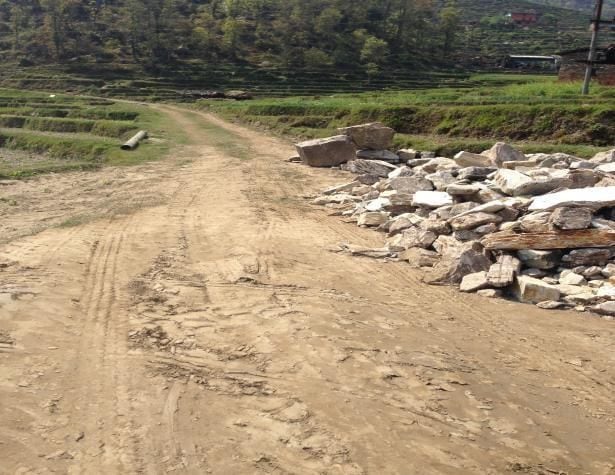

    Access Road

    About 17 km of access road from Balephi Bazaar to the headworks and powerhouse has been upgraded and protected.

    Read update

Our Network

  • BIG GROUP
  • K.B.N.R Isuwa Power Limited
  • Joshi Hydropower Development Company Limited
  • Isuwa Energy Hydropower Pvt. Ltd.

Contact

Talk to Us

Questions about the project, the share issue or working with us? Use the form or call our office in Kalopul, Kathmandu, Sunday to Friday.
