Headworks

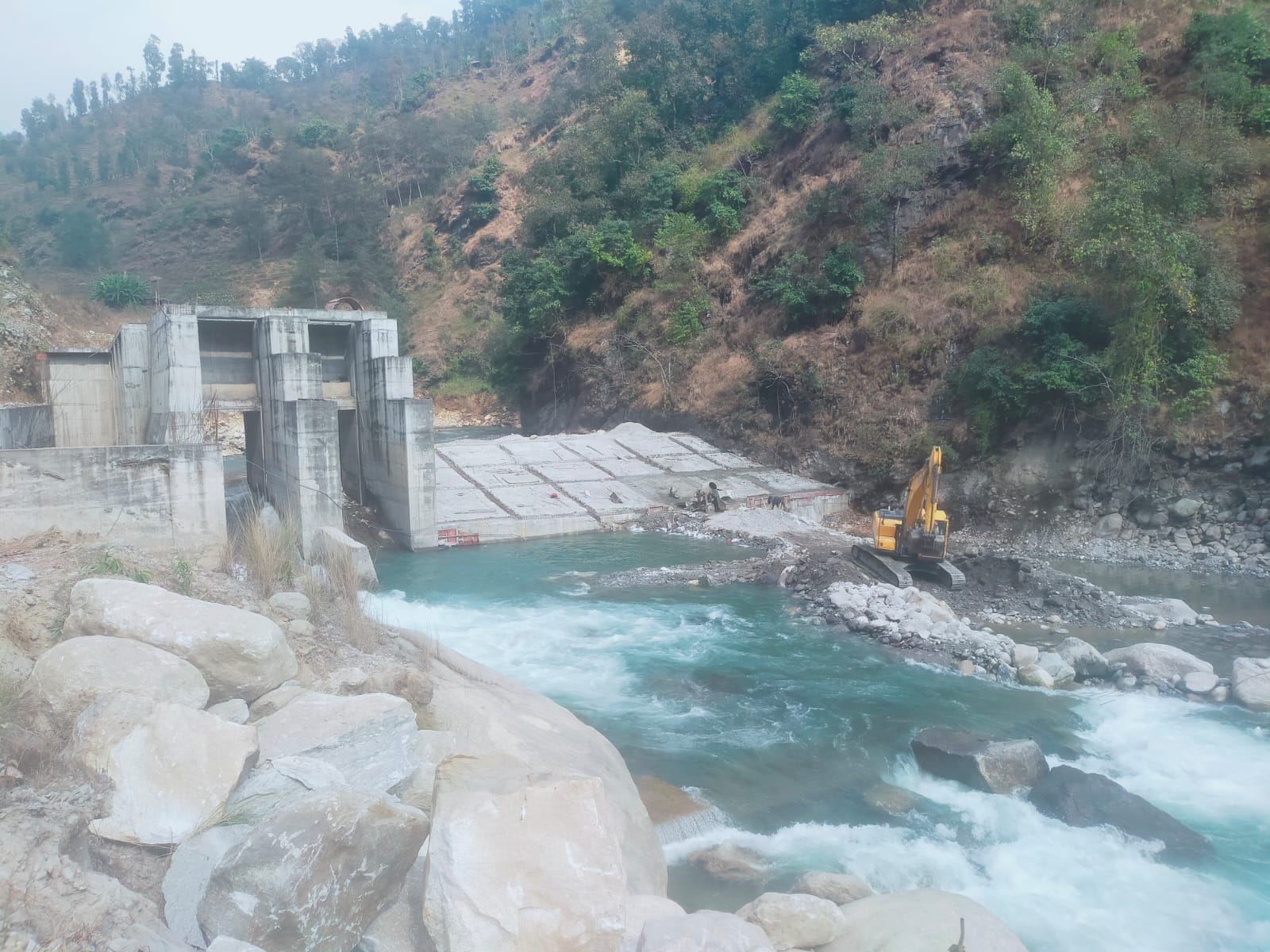

The weir, intake, under-sluice, spillway and gravel trap are fully constructed at the headworks site.
Construction Progress
How far each part of Balephi-A has come, from the weir to the transmission line. Figures as of August 2026.
Overall Status
As of August 2026
Site Updates
Notes from each part of the scheme, in the order the water flows.
The weir, intake, under-sluice, spillway and gravel trap are fully constructed at the headworks site.

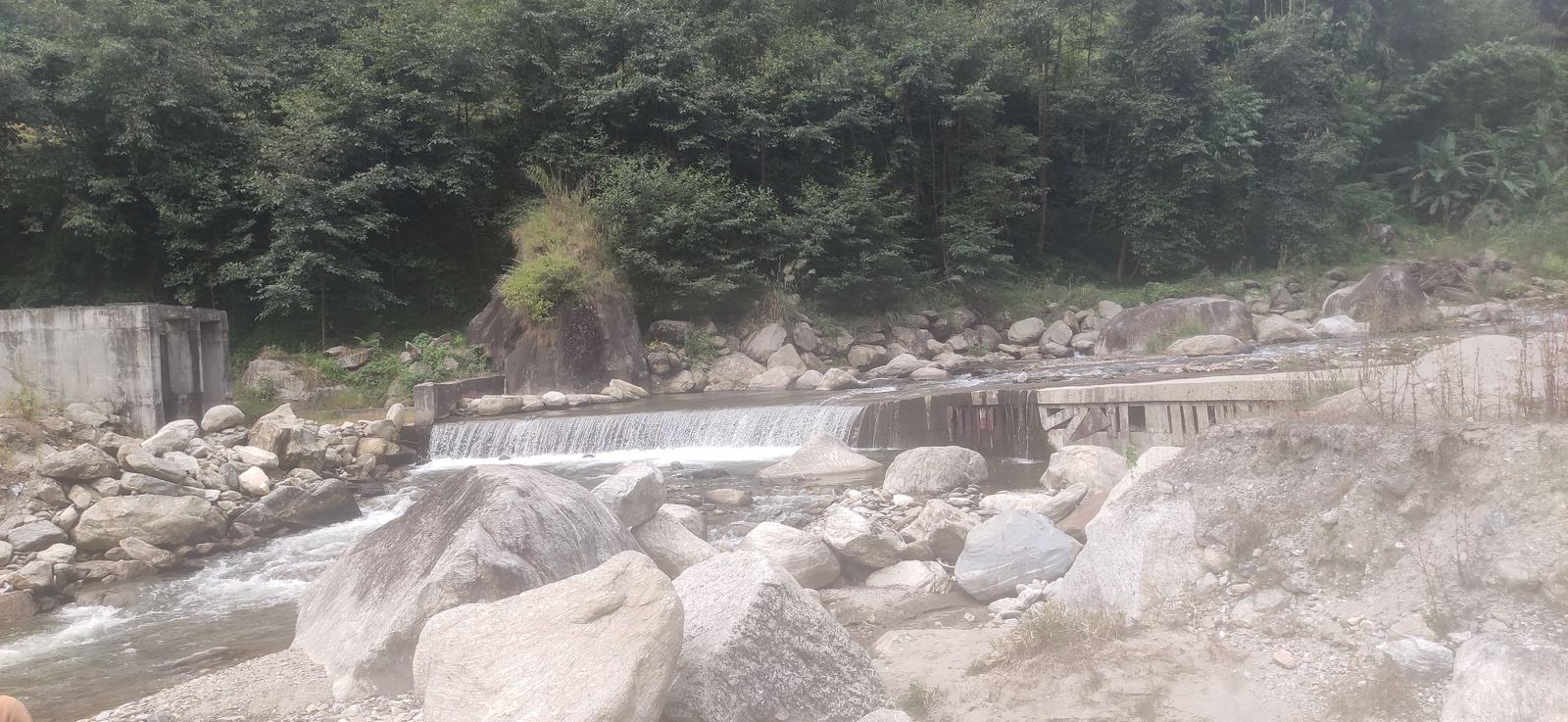

The 82 m approach canal connecting the gravel trap and the settling basin is fully complete.

Excavation, the main body, the pond and the hopper wall of the settling basin are complete.

910 m of the 948 m headrace canal linking the settling basin to the forebay is complete.

Site clearance, the bottom slab, side walls and bellmouth installation are fully complete.

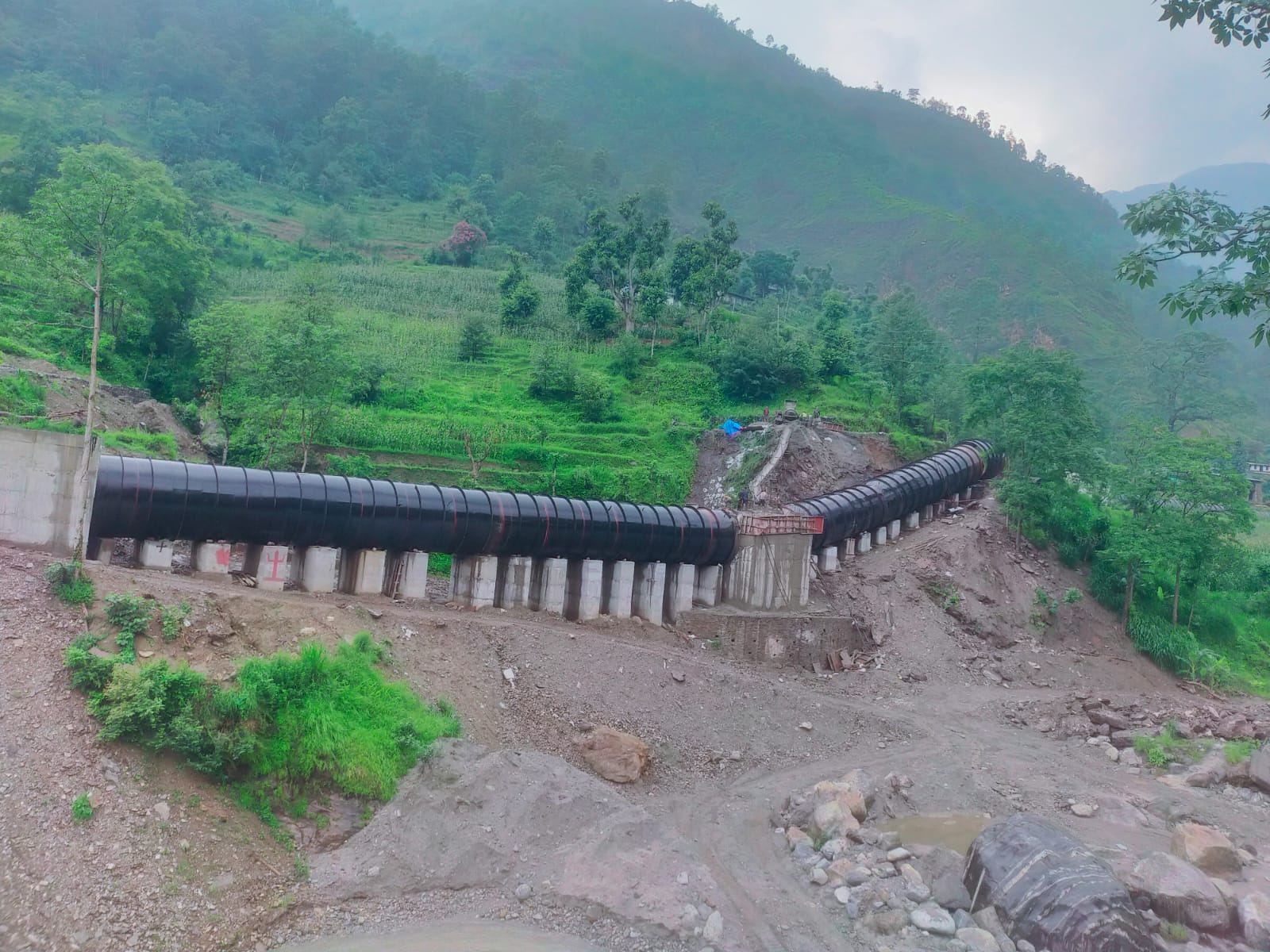

Of the 2,945 m of combined headrace and penstock pipe, about 2,061 m has been rolled and erected.

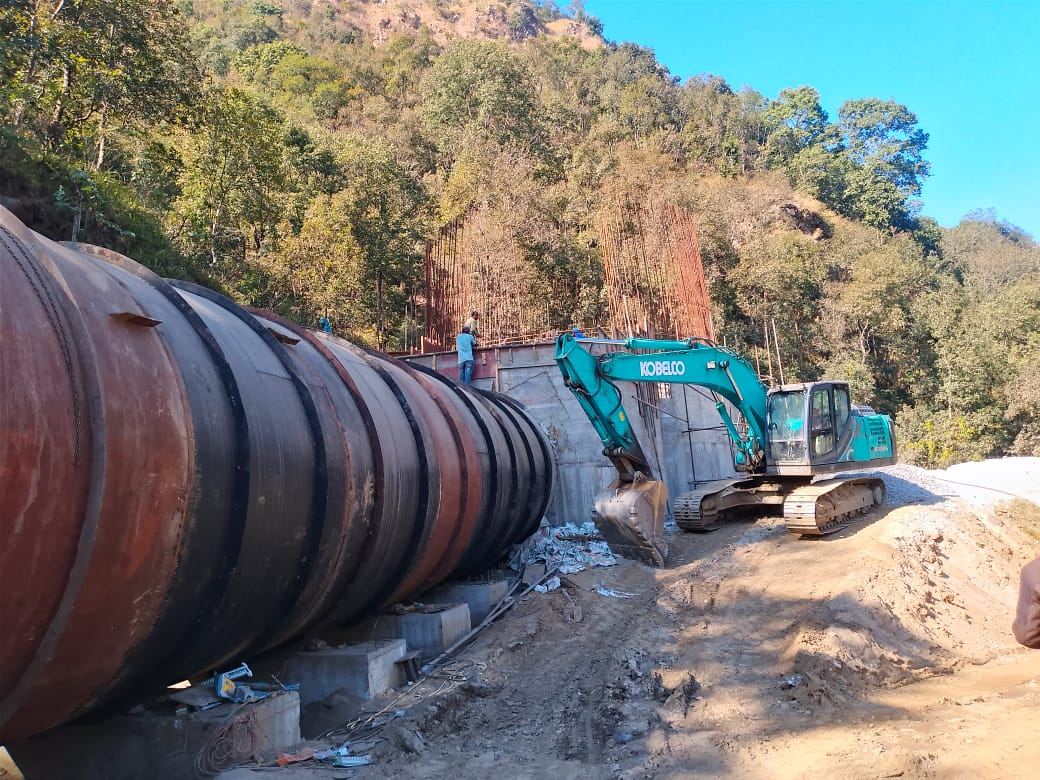

The surge tank has been fully excavated and constructed.

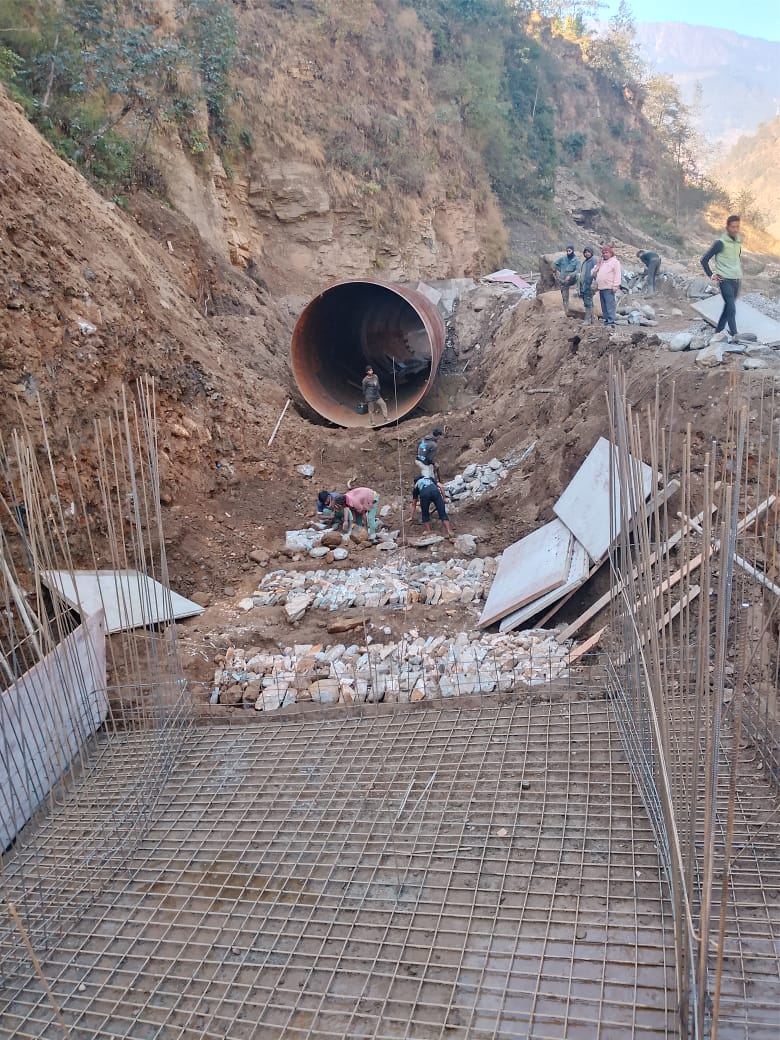

Site clearance, excavation and construction of saddle supports and anchor blocks are underway along the penstock alignment.

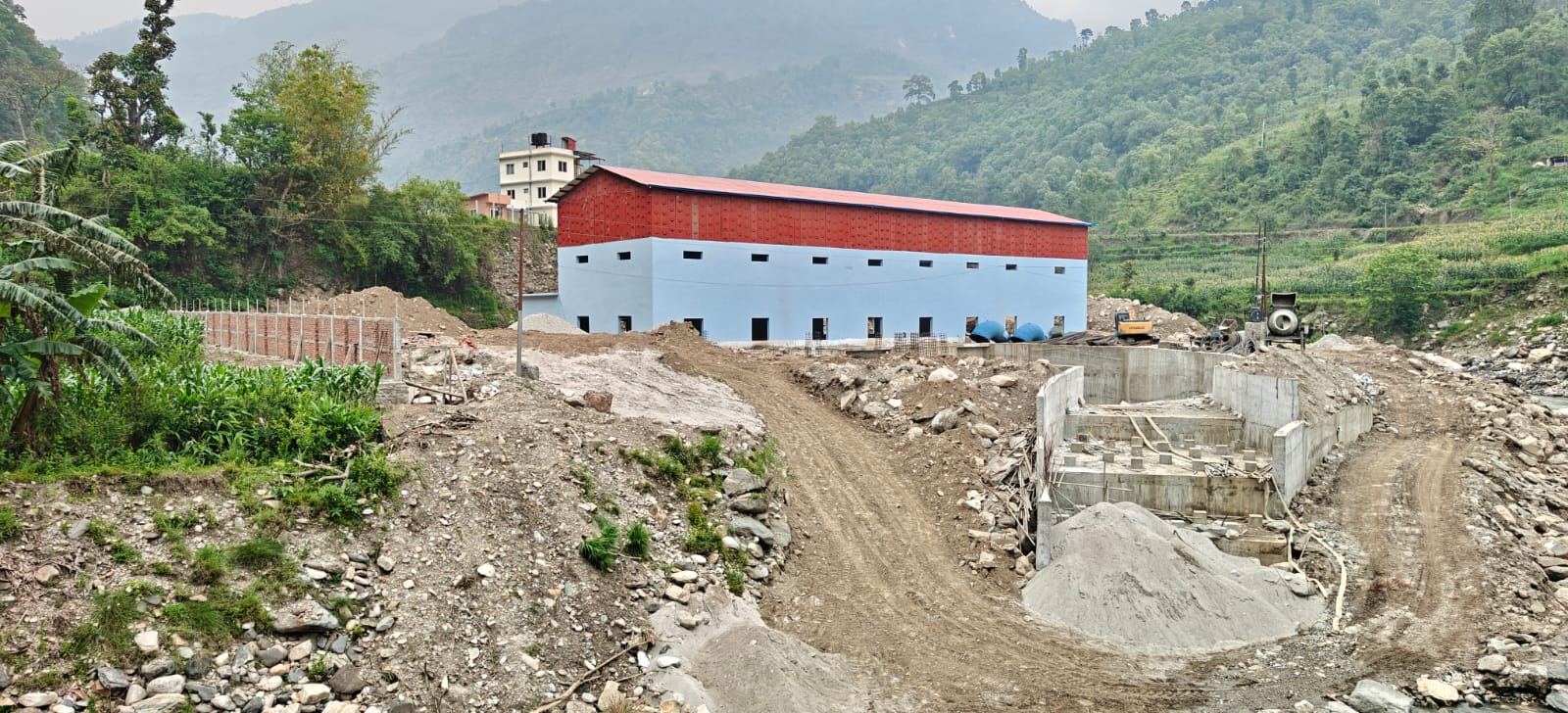

The foundation, earth mat, PCC works and superstructure are complete, and finishing works continue. Turbine and generator components, including the draft tube and main inlet valve, are being delivered and installed.

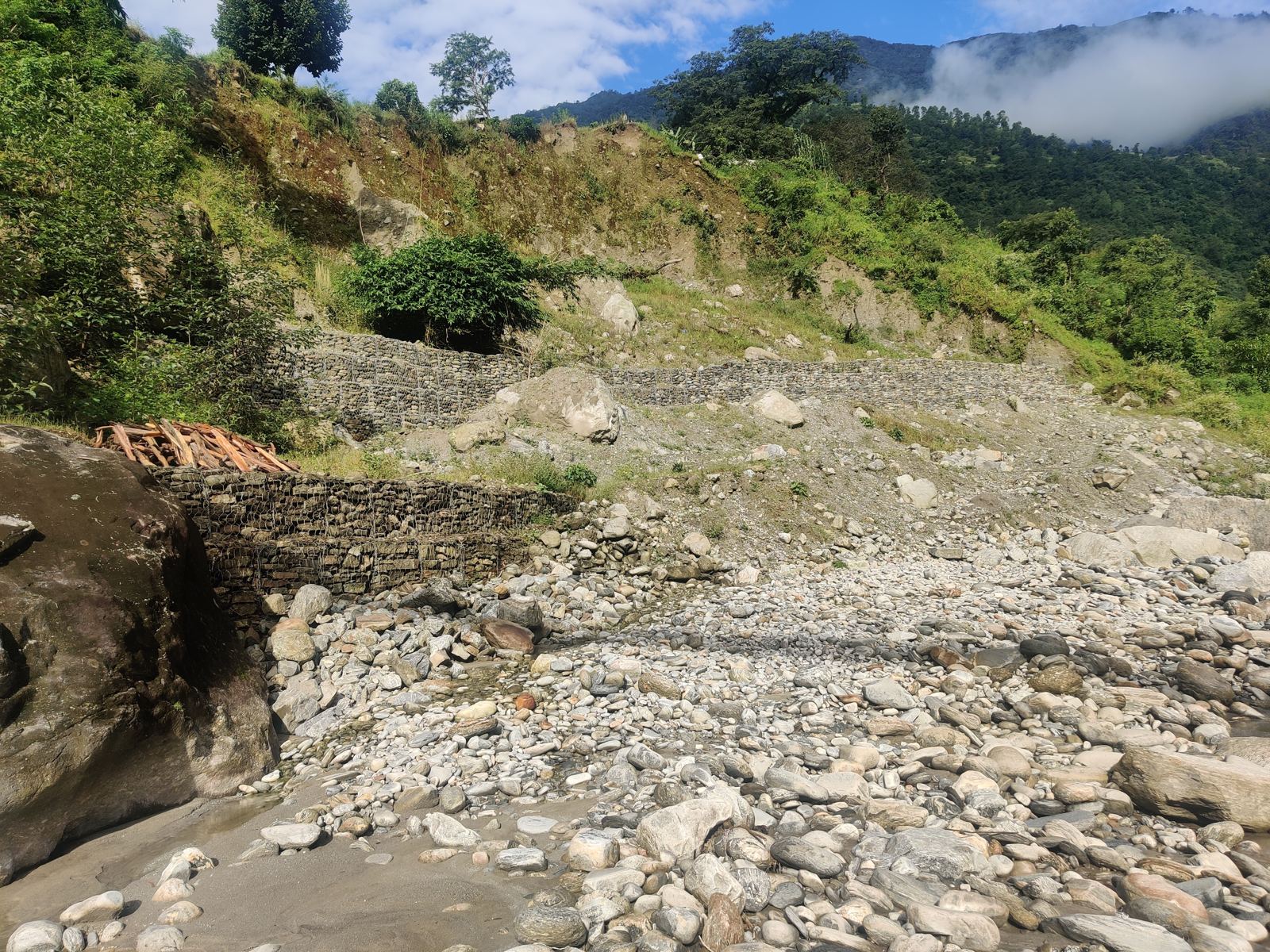

Stone masonry retaining structures are under construction to protect key project areas.

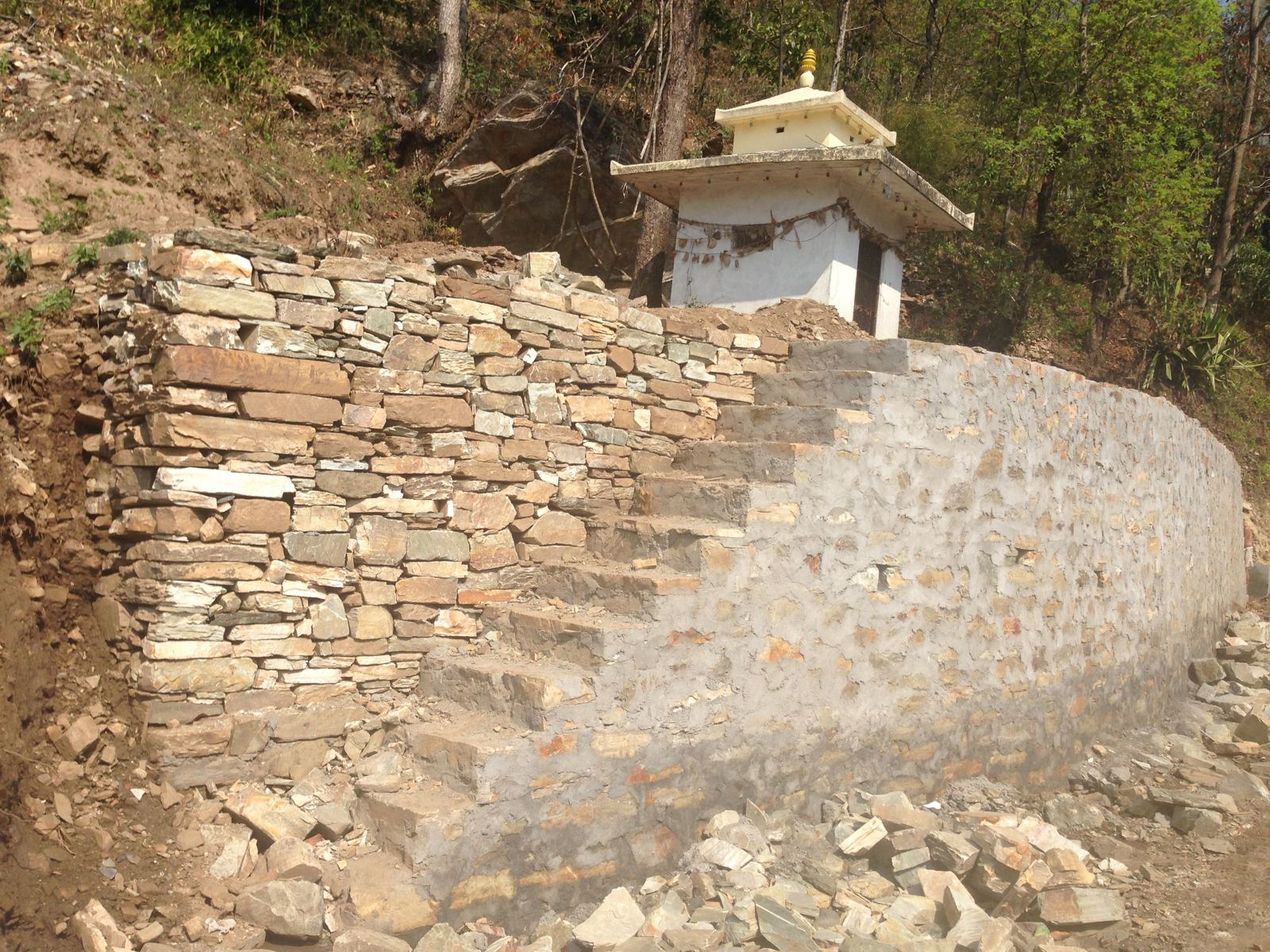

About 9 km of local roads, an irrigation canal, and protection works for the Mahadev Mandir and a local school are complete.

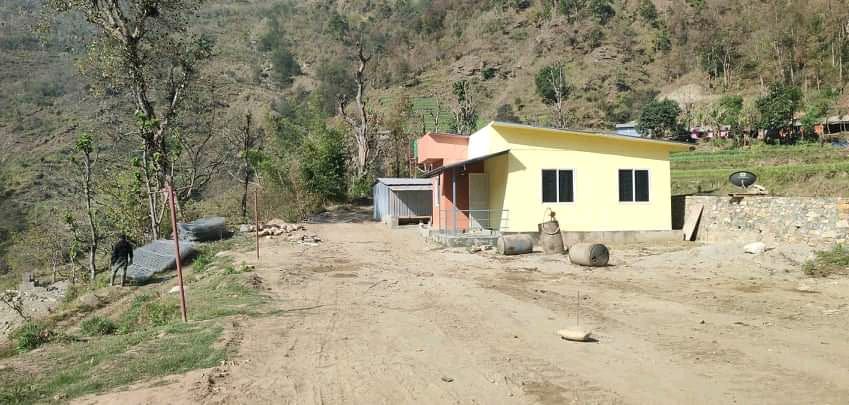

Site camps, stores, stockyards and fabrication workshops are in place near the headworks and powerhouse.
About 17 km of access road from Balephi Bazaar to the headworks and powerhouse has been upgraded and protected.
